Harris Road

Location of roadwork:
Michigan Avenue to Holmes Road

Township:
Ypsilanti

When is the work being done:
March - October 12

Description of work:
Road Reconstruction

Impact on Traffic:
Road closed to through traffic

Funding Source(s):
Federal, Four-Year Road and Non-Motorized Path Millage, Ypsilanti Community Utilities Authority

Latest Updates

October 12, 2018 Road Reopened: Harris Road

WHEN: Effective Thursday, October 11, 2018

WHERE: Harris Road between Michigan Avenue and Holmes Road in Ypsilanti Township

WHY: Completion of road improvement project

BACKGROUND: On Thursday, October 11, 2018 the Washtenaw County Road Commission (WCRC) re-opened Harris Road between Michigan Avenue and Holmes Road in Ypsilanti Township.

CONTACT: If you have any questions concerning this project, please contact Matt MacDonell, director of engineering (734) 327-6688 or macdonellm@wcroads.org

For more information about WCRC road closures and re-openings visit wcroads.org/news/media-advisories.

ISSUE DATE: 10/12/18

October 10, 2018 Nearly There!

It has been a long summer of construction on Harris Road in Ypsilanti Township but we are almost done!

The top layer of paving was completed yesterday on Harris Road and our contractor is now working to complete a punch list of items, including the pavement markings. Once this work has been completed, the road will be reopened to all traffic. We’re hoping to have the road officially open by the end of next week.

Thank you so much for your patience throughout this project.

If you have questions, please contact Matt MacDonell, director of engineering, (734) 327-6688 or macdonellm@wcroads.org.

September 27, 2018 Work Resumes on Harris Road

The labor dispute that has halted work on Harris Road for the past three weeks has come to a temporary resolution. Paving on Harris Road between Michigan Avenue and Holmes Road is scheduled to resume sometime in the next week. Once paving has been completed, the road will be reopened to all traffic.

To read more about the dispute, visit: mlive.com/news/labor_dispute

Thank you for your patience during this unusual time. If you have questions, please contact Matt MacDonell, project manager, (734)327-6688 or macdonellm@wcroads.org.

September 4, 2018 Work Stoppage Impacts Harris Road Project

As of 7 a.m. this morning, many projects on county roads in Washtenaw County are on hold due to a labor dispute between the Michigan Infrastructure Transportation Association (MITA) and the Operating Engineer’s Local 324. The Washtenaw County Road Commission (WCRC) is not a party to these negotiations.

This work stoppage halts all paving, and some earthwork and underground work done by contractors on county roads. On the Harris Road project, our contractor will continue with some work but will be unable to lay the final layer of asphalt until this labor dispute has ended.

Please contact Matt MacDonell, project manager, if you have any questions – macdonellm@wcroads.org or (734) 327-6688.

Click read the work stoppage press release issued by WCRC.

August 23, 2018 It’s Paving Time!

We are getting closer to the finish line on this project, check out the drone photo below to see all the progress we have made over the past month.

On Monday, August 27, 2018, our contractor will begin asphalt paving on Harris Road between Michigan Avenue and Holmes Road. We will be placing three layers of asphalt, the first two layers, also known as the “base” and “leveling course” will be placed next week.

After those layers have been placed, we have some additional non-asphalt work to complete before we can come in with the final, “top course” of asphalt. We will send out another email update before we apply this last layer.Once we have completed the last layer of asphalt, our contractor will then install pavement markings, completing our road work.

During paving, residents and property owners, who live or work internal to the project limits, will be provided access to their home or business but drivers should expect delays. We expect all work to be completed by mid-September. However, as with all construction, exact dates are tentative and subject to change due to weather conditions.

If you have any questions, please contact Matt MacDonell, project manager at macdonellm@wcroads.org or (734) 327- 6688 with any questions.

Thank you again for your patience!

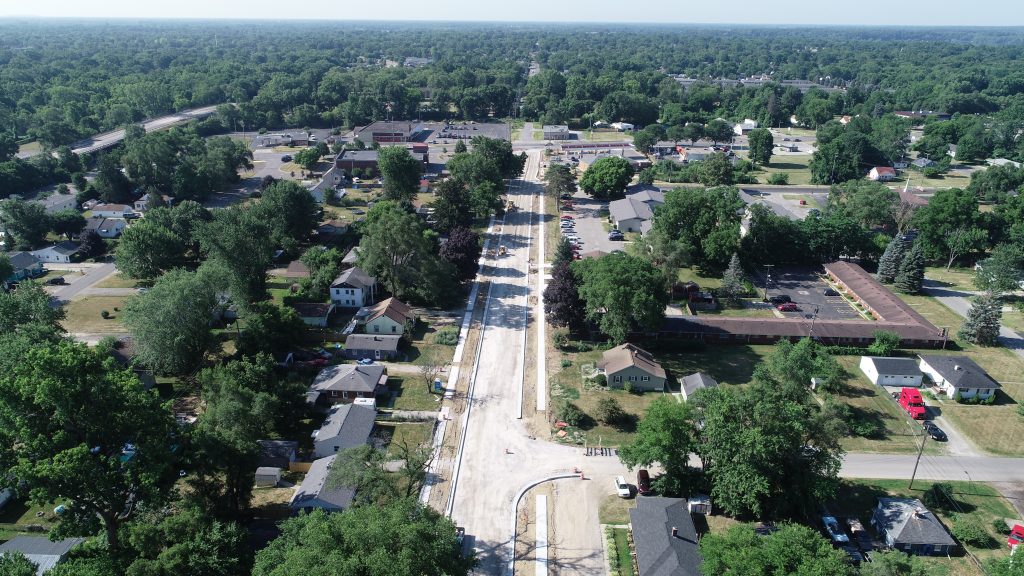

Harris Road August 23 Progress Photo

Harris Road Progress Photo – August 23, 2018

July 19, 2018 Harris Road Concrete Work is Shifting North

Starting Monday, July 23 (if the weather cooperates), Bailey Excavating, our Harris Road project contractor, will be working on concrete curb and gutter on Harris Rd between Forest Ave and Holmes Rd. As a reminder, you will not be able to drive where they are pouring concrete or on freshly poured concrete (for up to 3 days). If your driveway is blocked, you will be allowed to park temporarily on the street until the concrete has cured.

Bailey Excavating will be back in a few weeks to pour concrete sidewalks and driveway approaches in this area. We will send out another update before that work begins.

In addition, DTE and its contractor will begin work on the underground facilities required for street lighting. They will start between Michigan Ave and Forest Ave and then move north as the concrete curb is completed.

If you have any questions, please contact Matt MacDonell, project manager at macdonellm@wcroads.org with any questions.

Thanks again for your patience and have a wonderful weekend.

July 12, 2018 The Harris Rd Reconstruction Project Rolls Onward!

It’s already been a busy July on Harris Road; we’ve completed all the underground utility work and Bailey Excavating, our project contractor, will continue to work on concrete sidewalks, gutters, curbs, and driveways, while also preparing the road for paving.

We are on track to have the road reopened to traffic sometime in mid to late August. If you have any questions, please contact Matt MacDonell, project manager at macdonellm@wcroads.org with any questions.

Thanks again for your patience!

Click here to visit our Facebook page and view the drone video!

Harris Road Reconstruction Project from "drone's-eye view" on June 12, 2018

Harris Road Reconstruction Project from “drone’s-eye view” on June 12, 2018

June 25, 2018 It’s Concrete Time!

This morning, Bailey Excavating, our Harris Road project contractor, started pouring concrete sidewalk on the south end of the project. They will continue to pour concrete for sidewalks, curb and gutter and driveways over the next few weeks.

There will be times during this process when you won’t be able to use your driveway. You will not be able to drive where they are pouring concrete or on freshly poured concrete (for up to 3 days). Concrete is a great material but it needs to “cure” or cool down and harden once it has been poured. The curing process usually takes 3 days for this type of work.

If you cannot access your driveway, our contractor, Bailey Excavating, will provide you with an alternative location to park your vehicles.

We know this will be inconvenient and we appreciate your patience.

If you have any questions, please contact Matt MacDonell, project manager at macdonellm@wcroads.org with any questions.

June 11, 2018 Harris Road Project Update

This week, as the storm sewer work continues, we will mill away the pavement of the Harris Road and start the earthwork required to build the road base. These are the first steps in the pavement reconstruction process. People who live within the work zone will still have access to their residence but there may be delays as the crews are working.

We are still on track to have the road back open to traffic at the end of July as long as the weather cooperates. We appreciate everyone’s continued patience during this project.

May 8, 2018 Water Main has been Installed!

Bailey Excavating, the Harris Road project contractor, has installed the water main between Michigan Avenue and Forest Avenue. The next step is to connect the existing water system to the new main. They will begin this work today and it will take them until at least next week to complete.

If your water service will be impacted, you will be contacted by a representative from OHM Advisors, the Ypsilanti Community Utilities Authority (YUCA) or Bailey Excavating in advance of your water service being connected to the new system.

Residents can expect a brief water outage during this changeover and they will be notified in advance of when this outage will take place.

Thanks for your patience!

April 25, 2018 Harris Road Mailboxes Have Been Relocated

The mailboxes within the project limits have been temporarily relocated by the contractor.  Two locations have been set up outside the work area at the intersections of Oak St & Harris Rd and Forrest Ave & Harris Rd.

Near the completion of the project, the contractor will reinstall each mailbox with a new post as close to it’s previous location as possible.

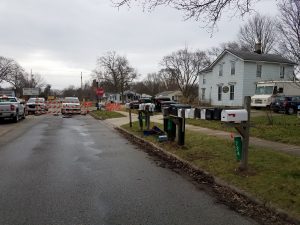

Relocated mailboxes on Forrest Ave.

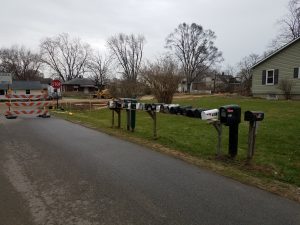

Relocated mailboxes on Oak St

April 20, 2018 Harris Road is Off to a Good Start!

The Harris Road reconstruction project is officially underway!  Here’s a brief update on our progress to date:

  • Water main installation is underway by the Washtenaw County Road Commission (WCRC) road contractor.
  • DTE – Gas is working to complete the gas main installation and customer service connections.
  • The WCRC road contractor is scheduled to begin construction of the storm sewer and drainage structures in the next week.
  • Mailboxes will soon be temporarily relocated by the road contractor.  Your mailbox will be located outside the work area near the closest intersection.

Feel free to contact Matt MacDonell, WCRC project manager at macdonellm@wcroads.org with any questions. Have a great weekend!

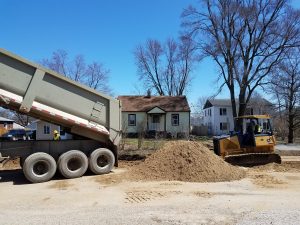

Back fill being delivered for the water mainline trench on Harris Road.

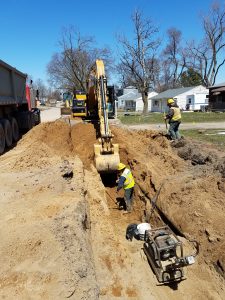

Contractors working on the water mainline installation on Harris Road.

March 29, 2018 Road Closure: Harris Road

WHEN: Monday, April 2, 2018 until further notice

WHERE: Harris Road between Michigan Avenue and Holmes Road in Ypsilanti Township

WHY: Harris Road Reconstruction Project

BACKGROUND: On Monday, April 2, 2018, the Contractor for the Washtenaw County Road Commission (WCRC) will CLOSE Harris Road between Michigan Avenue and Holmes Road in Ypsilanti Township for the Harris Road project.  The two lane roadway will be reconstructed including bike lanes, concrete curb, driveways, sidewalk, street lights, rain gardens, storm sewer, and water main.

The WCRC expects the work to be completed by the end of July 2018.  However, please be advised that due to weather conditions, all dates are tentative and subject to change. The road will be closed to all through-traffic during construction. This includes the closure of all intersections such as Forest Avenue.

The posted DETOURS for this project are as follows:

  • Harris Rd: Use Burbank Rd to Cross St to Prospect Rd to Holmes Rd
  • WB Forest Rd: Use NB Ford Blvd to WB Holmes Rd to SB Prospect Rd
  • EB Forest Rd: Use NB Prospect to EB Holmes to SB Ford Blvd
  • EB Cross St: Use Burbank Rd to Michigan Ave

To read more about this project and sign up for email updates visit: http://www.wcroads.org/wcrc-project/harris-road-2/

CONTACT: Please contact Matt MacDonell, WCRC Assistant Director of Engineering, at (734) 327-6688 or macdonellm@wcroads.org if you have questions or concerns in regards to the project.

For more information about Washtenaw County Road Commission road closures visit wcroads.org/news/media-advisories.

ISSUE DATE: 03/29/18

March 23, 2018 Harris Road Closure Delayed One Week

Due to seasonal weight restrictions, the closure of Harris Road to through traffic will be delayed one week. The road will be closed starting Monday, April 2, 2018, weather dependent.

Utility relocation work will continue during the week of March 26, 2018.

March 8, 2018 March 21 Harris Road Construction Information Meeting

The Washtenaw County Road Commission (WCRC) will be reconstructing Harris Road between Michigan Avenue (US-12) and Holmes Road.

You are invited to a construction information meeting on Wednesday, March 21 at 6:30 p.m. at the Ypsilanti Township Fire Department Main Station, 222 S. Ford Blvd, Ypsilanti, MI 48198. WCRC staff will be in attendance to share construction details.

The Harris Road improvements will include:

  • The reconstruction of the two lane roadway between Michigan Avenue (US-12) and Holmes Road.
  • Installation of “complete street” infrastructure including bike lanes, concrete curb, driveway approaches, sidewalk and street lights.
  • New green infrastructure including rain gardens to help with drainage.
  • New utility infrastructure including gas main, water main and storm sewer.

Project Timeline:

Preliminary work has already started, a contractor for DTE Gas is currently installing new gas main and tree removal will likely begin the week of March 19.

Road construction will begin at the end of March. At this time the road will be closed for the duration of the project. Our goal is to complete the project by the end of July, weather dependent.

Detours and Access:

  • Harris Road from Michigan Avenue to Holmes Road will be closed to non-local traffic starting at the end of March through the completion of the project.
    • During this time, only residents and property owners, who live within the project limits, will be permitted to enter the construction work zone.
  • Non-residents will be required to follow posted detour routes while work is occurring.
    • Harris Rd traffic use Burbank Ave to Cross St to Prospect Rd to Holmes Rd.
    • WB Forest Rd traffic use NB Ford Blvd to WB Holmes Rd to SB Prospect Rd.
    • EB Forest Rd traffic use NB Prospect to EB Holmes to SB Ford Blvd
    • EB Cross St traffic use Burbank Rd to Michigan Ave.
  • WCRC will coordinate mail delivery and garbage collection during the duration of the project.

For more information:

  • Contact Matt MacDonell, Assistant Director of Engineering, 734-327-6688, macdonellm@wcroads.org
  • Follow @WashtenawRoads on Facebook and Twitter
Contact information:
Matthew MacDonell
    • 734-327-6688
